WHAT IS MEASURE L
Measure L is a 25-year, ½ cent sales tax approved by Stanislaus County voters by an overwhelming 71.95% in November of 2016. Measure L provides funding for local transportation improvements including, but not limited to: fixing potholes and maintaining streets; improving emergency response; providing safe routes to schools; providing senior, veterans and disabled shuttle services; and improving safety and reducing traffic congestion on Highway 99 and major streets.
HOW WILL THE CITY OF WATERFORD USE THE MEASURE L FUNDS
Waterford developed a list of streets in need of maintenance and repairs for inclusion in our expenditure plan. The expenditure plan may be modified from time to time as needs and as priorities change. For example, priorities may change when we look at other factors like city and private utility work or grant funding availability. Projects funded or will be funded in the future in accordance with the current expenditure plan are as follows:
LOCATION | LIMITS | Description | FUNDS EXPENDED TO DATE | STATUS |
Summers Street | F St to La Gallina | Reconstruction of roadway and replacement of ramps not meeting ADA and sidewalk in disrepair. | $459,140 | Complete 2019 |
Church Street | Yosemite to Kadota | Reconstruction and slurry seal of roadway and installation of sidewalk and replacement of ramps not meeting ADA and sidewalk in disrepair. | $123,539 | Complete 2019 |
Main Street | G to Church | Reconstruction of roadway and replacement of ramps not meeting ADA and sidewalk in disrepair. | $402,685 | Complete 2021 |
Acosta, Brisk, Paaga, Burns Creek, Fearl and S. Westerns | Entire Roadway surface except Western. Western from Yosemite to Washington | Cape Seals of roadway and replacement of ramps not meeting ADA and sidewalk in disrepair. | $577,839 | Complete 2022 |
Non-Capital | N/A | LRS Match, Street Saver Subscription, Pavement Management Program | $15,495 | Complete 2022 |
Yosemite, F Street, Bentley, Reinway and Welch | Intersections with uncontrolled crosswalks | Installed flashing beacons at heavy use uncontrolled crosswalks. | $80,329 | Complete 2022 |
F Street Pedestrian | West side of roadway from Rose to Western. | Installing missing sidewalk and installation of an ADA ramp. | $318,940 | Complete 2024 |
Yosemite & Pasadena | Intersection of Yosemite and Pasadena | Installation of a traffic signal. | $18,770 | Construction Bidding |
F Street Overlay | Yosemite to Bonnie Brae | Overall F Street from Yosemite to Bonnie Brae. | $830,350 | Complete 2024 |
Skyline Improvements | Skyline – Yosemite to Bentley | Skyline rehabilitation project from Yosemite to Bentley. | $57,198 | Complete 2024 |
B Street | Bentley to Dorsey | |||
G Street | Yosemite to Church | |||
D Street | Bentley to Main | |||
E Street | La Gallina to Oden | |||
Welch Street | Tim Bell to Tohara | |||
Kadota Avenue | Pasadena to Western | |||
Harriet Drive | Bentley to Enid | |||
Hickman Street | Baker to N. Appling |
Total Funds Expended to Date (to 6/30/2024) | $2,884,285 |
Total Funds Received to Date (to 6/30/2024) | $3,064,305 |
Total Funds Available **(to 6/30/2024) | $180,020 |
** The Total Available Funds will accumulate until sufficient funds are available for the next improvement project(s).
Measure L Status Report 9-30-2019 Waterford
Measure L Status Report 12-31-2019 Waterford
Measure L Status Report 3-31-2020 Waterford
Measure L Status Report 6-30-2020 Waterford
Measure L Status Report 9-30-2020 Waterford
Measure L Status Report 12-31-2020 Waterford
Measure L Status Report 3-31-2021 Waterford
Measure L Status Report 6-30-2021 Waterford
Measure L Status Report 9-30-2021 Waterford
Measure L Status Report 12-31-2021 Waterford
Measure L Status Report 3-31-2022 Waterford
Measure L Status Report 6-30-2022 Waterford
Measure L Status Report 9-30-2022 Waterford
Measure L Status Report 12-31-2022 Waterford
Measure L Status Report 3-31-2023 Waterford
Measure L Status Report 6-30-2023 Waterford As Modified 10.16.2023
Measure L Status Report 12-31-2023 Waterford
Measure L Status Report 3-31-2024 Waterford
Measure L Status Report 6-30-2024 Waterford
Waterford Measure L Projects
Summers St. – F Street to La Gallina Ave
Church Street – Yosemite Blvd. to Kadota Ave.
2020 Main Street Improvement Project
Completed 2021/2022 Surface Improvement Project
Completed in 2022:

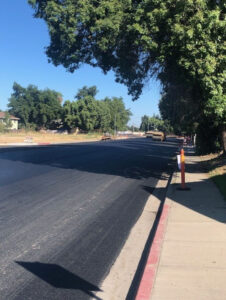

2024 F Street Overlay Project
For more information regarding Measure L Funds in the City of Waterford, please Contact Public Works Superintendent Lonnie Statzer, (209) 874.2328, Ext. 130
For additional information, visit: www.stancog.org or stanislausmeasurel.com/
